Context
As battery storage becomes standard on utility-scale projects, the tracker vs. fixed-tilt decision interacts with BESS sizing in ways that flat-field simulation misses entirely. On sloped terrain, tracker row spacing, pile length distributions, and ground coverage ratios differ significantly between configurations — affecting both energy yield and civil cost.
Approach
PVX.AI modeled both configurations on the same terrain:

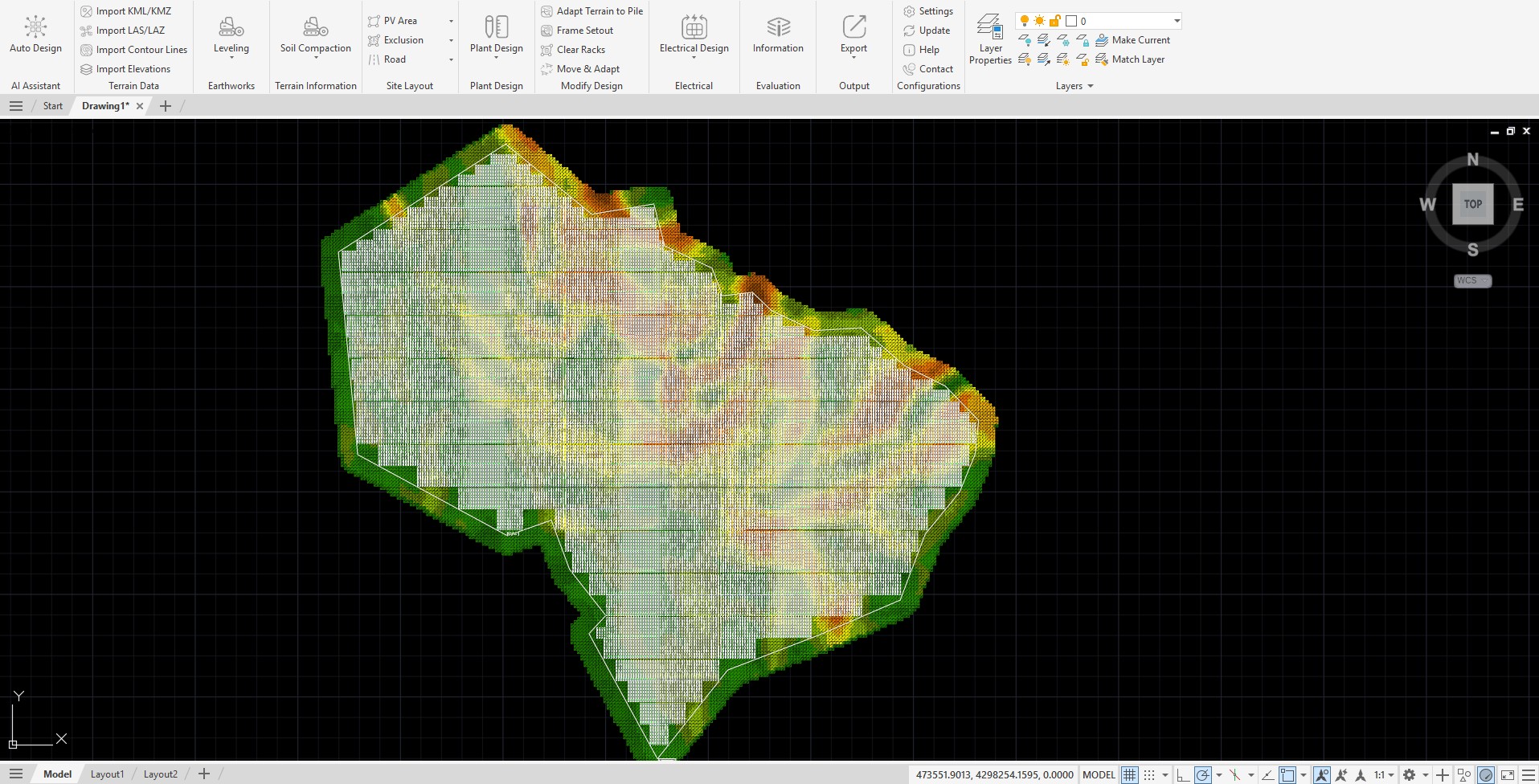

- Single-axis tracker — terrain-adaptive row placement, pile lengths optimized against slope

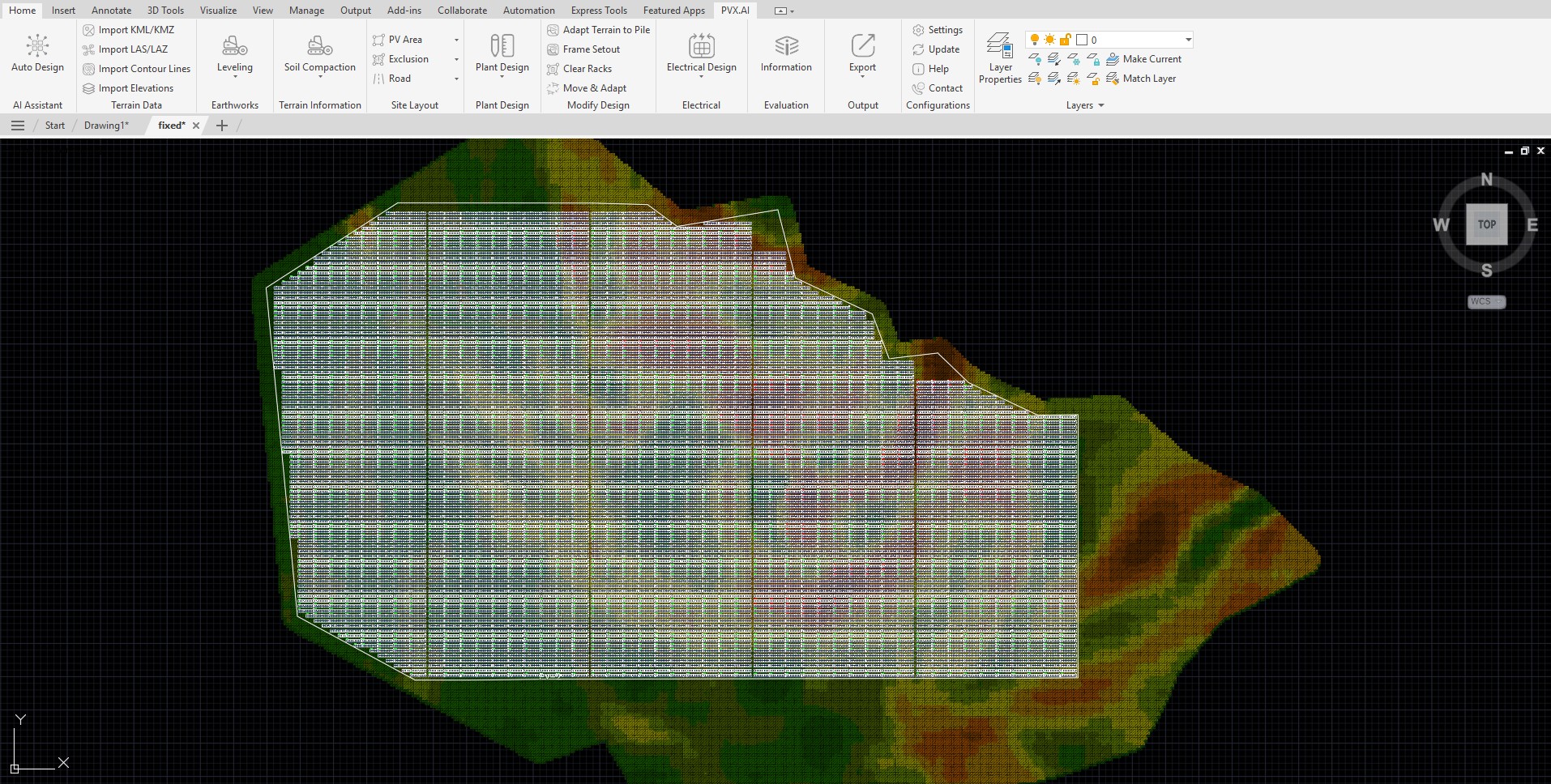

- Fixed-tilt — arrays tilted to optimal angle, higher packing density, lower civil cost
Both configurations were sized for the same land boundary and AC interconnect capacity. BESS was sized to capture curtailed energy in each scenario.
Results
- Tracker generated 16.9% more energy than fixed-tilt on the same site
- Fixed-tilt reduced civil cost by 31% due to simpler grading and shorter piles
- BESS reduced curtailment by 22% in the tracker configuration, improving the revenue case
- Net LCOE favored tracker in high-irradiance zones; fixed-tilt was preferred on ridge terrain above 35° slope
Design Insight
The 16.9% energy advantage of tracker was partially offset by higher civil cost on steep terrain — a trade-off invisible in flat-field simulation. Terrain-aware modeling showed that a hybrid approach (tracker on lower slopes, fixed-tilt on ridge areas) captured 94% of the tracker energy advantage at 78% of the tracker civil cost.
